A Guide to Setting Up BaseNYC's % Complete Document
Learn how to effectively manage project finances using the % Complete document at Base Design New York.
In this guide, we'll learn how to effectively setup the % complete document that is used in BaseNYC to manage project finances at an individual project level. This document is crucial for tracking project progress and ensuring financial alignment with the project's budget and timeline. We'll explore how to access the template via Google Sheets, set up the project using the proposal and project burn data, and manage the financial aspects throughout the project. An accurate initial setup of the % Complete for a project will provide you with a deep understanding of the project finances, and make it easy for you to make adjustments throughout the lifespan of a project.


This document contains four tabs: Project Setup, Percent Complete, Invoicing, and Instructions.

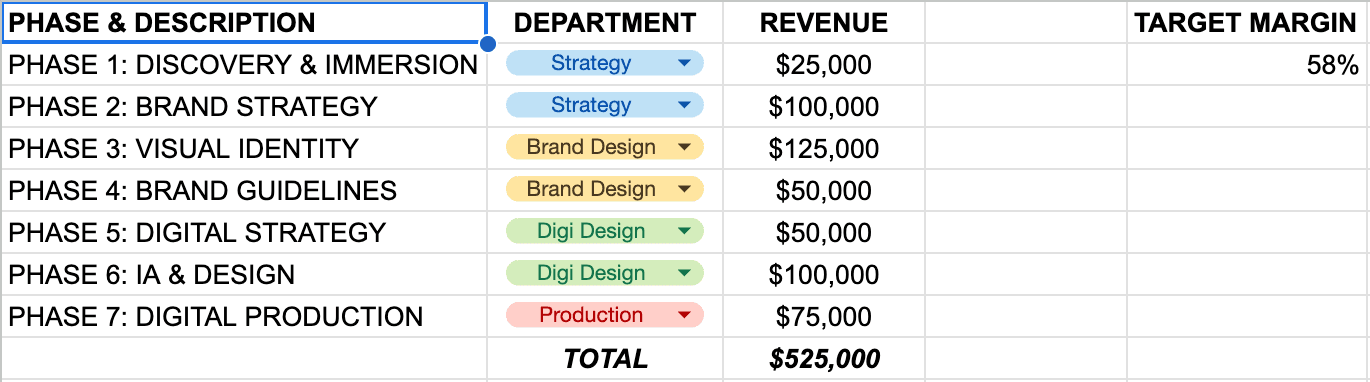

The most important sections are the project setup, percent complete, and invoicing tabs. The instructions tab provides extra details on usage. In the project setup tab, input the proposal information into the document. There are four key columns: phase, description, department, and designation. The phase and description should usually match the proposal's language. The department column indicates which department the phase belongs to.

You begin by entering each phase of the project, as per the proposal. For this example, we will use the default phases that are part of the template.

This is an important step to ensure that the project finances accurately reflect the type of work that is being done. If there is ever a question about which department a phase should be tied to, reach out to the Director of Operations to discuss.
Each phase has a drop down menu for you to select the appropriate department. The "TBD" option is there for phases that are yet to be defined, but should only be used as a temporary placeholder.

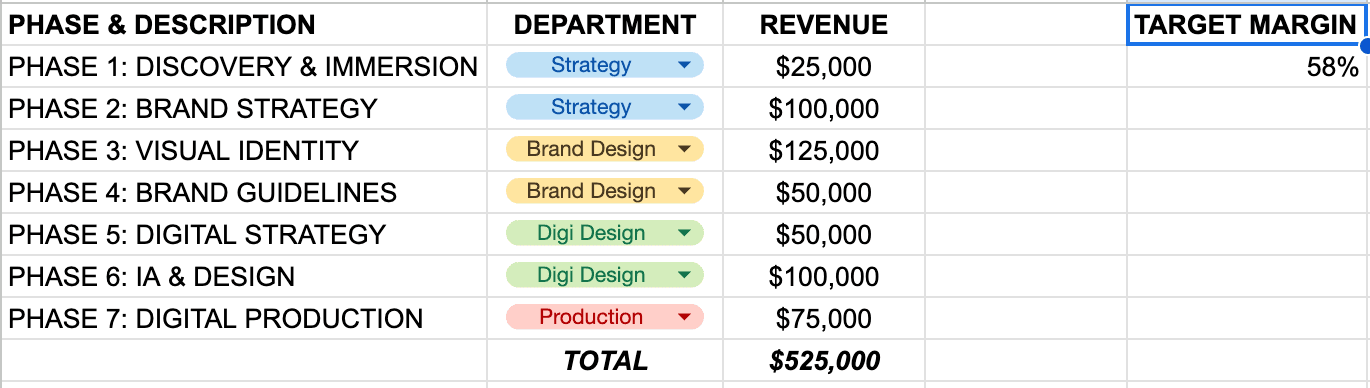

The "Target Margin" is a number that should be aligned upon with the Managing Director, Director of Operations and project team at the outset of the project. It is derived from the project burn which is completed prior to setting up the % Complete.


% COMPLETE TAB
The "% Complete" tab may look overwhelming at first, but don't be intimidated! It has a number of automations built in to help keep things simple.
This sheet pulls in the following data automatically from the "Project Setup" tab: Phase Description, Department by Phase, Budget by Phase, and Target Margin.

Click on cell D3 that says "Jan23".

One of the great features is that after changing this initial field, the remaining months automatically update throughout the rest of the sheet.

SETTING UP THE FINANCES

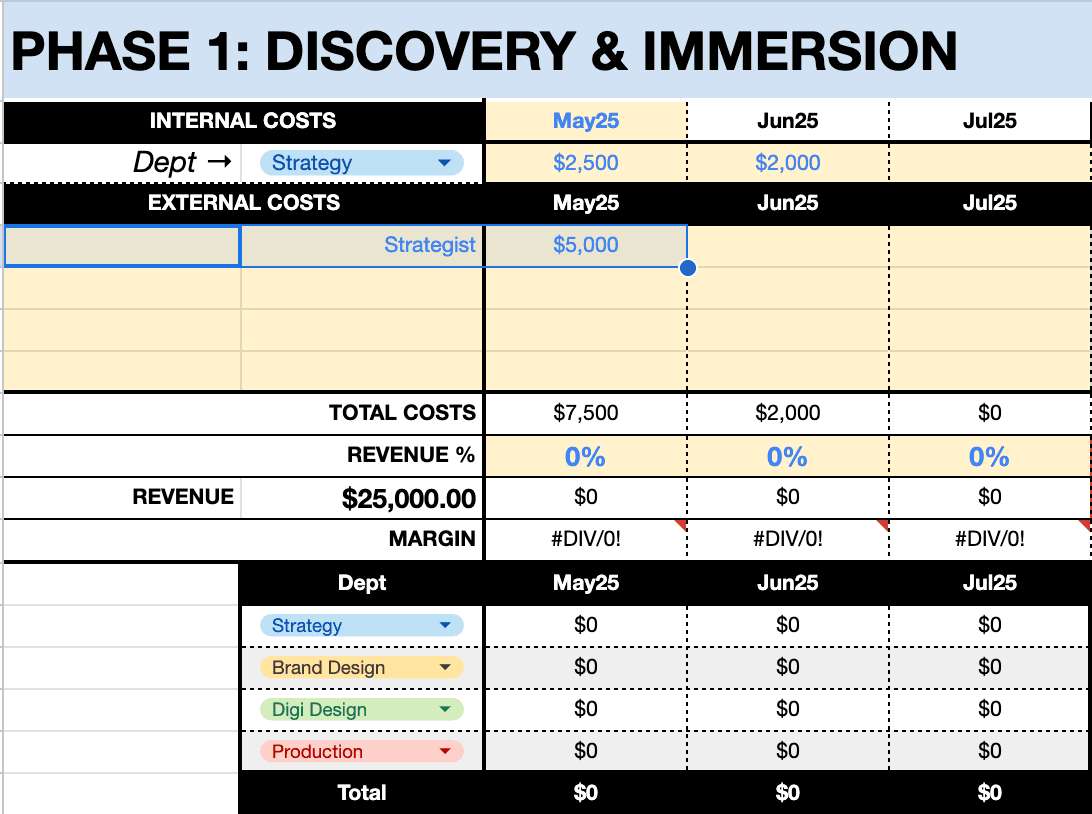

This is where things begin to get a bit more complicated. 😉 The first step is to enter all of the project costs, based on the PROJECT BURN.



To determine the appropriate REVENUE %, you need to consider three things:
1: The costs reflected in each month in your % COMPLETE
2: The projected duration of the PHASE
3: The TARGET MARGIN
In this example, PHASE 1: DISCOVERY & IMMERSION is projected to take place over the course of two months. This is reflected by the fact that there are only costs in both the month of May25 & Jun25. Therefore, we need to distribute the revenue across both months.
We will begin with the month of May25, and input a percentage that meets or exceeds our TARGET MARGIN of 58%. In this case, a REVENUE % of 75% gives us a MARGIN of 60%, which is what we will use in this case.

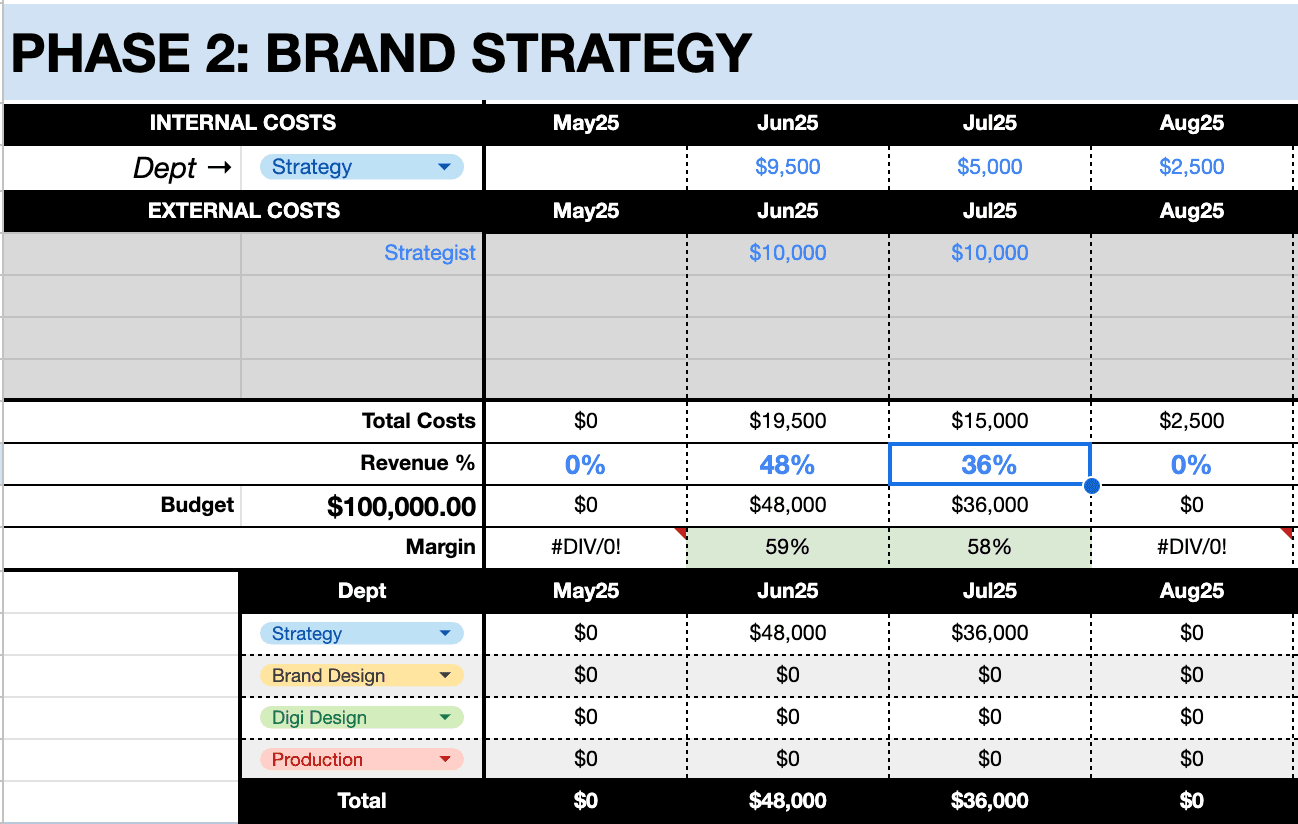

We will begin by applying a percentage to the first month (Jun25), with the objective of achieving a MARGIN that is equal to or greater than our TARGET MARGIN. In this case, 48% is close.





We can see that in each month, across all phases of the project, we are exceeding our TARGET MARGIN of 58%, and achieving a TOTAL MARGIN of 66.40% across the whole project.
